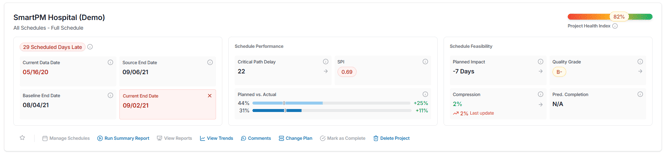

Card View Overview

Summary:

In Card View, your projects are displayed as individual cards that highlight key details at a glance. Each card includes important dates, schedule performance, and an up-to-date assessment of schedule feasibility based on the latest data date.



Important Dates:

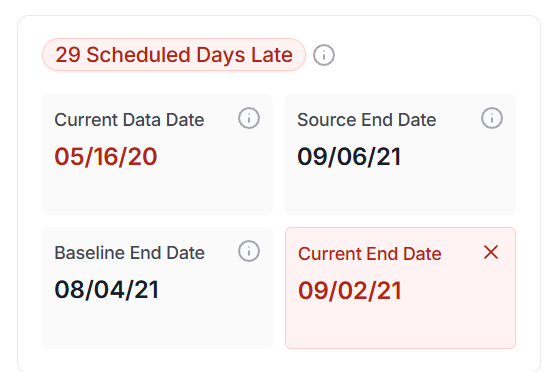

This section of the card highlights key schedule milestones and timing details, including:

  • The number of days your project is ahead of or behind schedule
  • Current data date: Representing the most recent schedule update
  • Baseline end date: Based on the earliest schedule in the primary scenario
  • Current end date: Reflecting the latest projected project completion as calculated by SmartPM
  • Source end date: Pulled from the end date shown in the latest version of the original schedule file

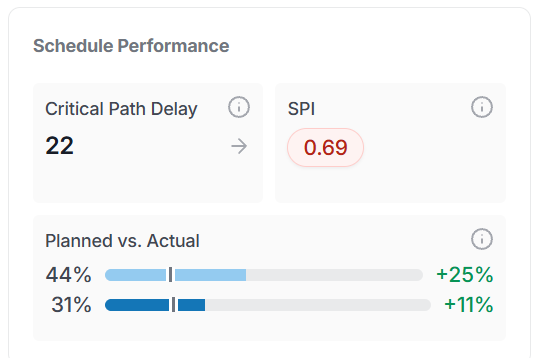

Schedule Performance:

Schedule Performance provides insight into how your project is tracking against the plan:

  • Critical Path Delay: The total amount of delay on the critical path based on progress reported to date.
  • Schedule Performance Index (SPI): A measure of how efficiently the project is progressing compared to the plan. It reflects the actual rate of progress achieved versus what was planned.
  • Planned vs. Actual Performance: A visual comparison of expected versus real progress. The top bar represents the planned performance, while the bottom bar shows the project’s actual performance.
    • The percentages on the left represent total progress from 0% for both planned and actual values. The percentages on the right show progress made since the baseline was established, again for both planned and actual.
    • The center line indicates the project’s status at the time the baseline was set.
    • For example, if the planned total progress is 44% and the planned progress since the baseline is 25%, this means the project was at 19% completion when the baseline was established.

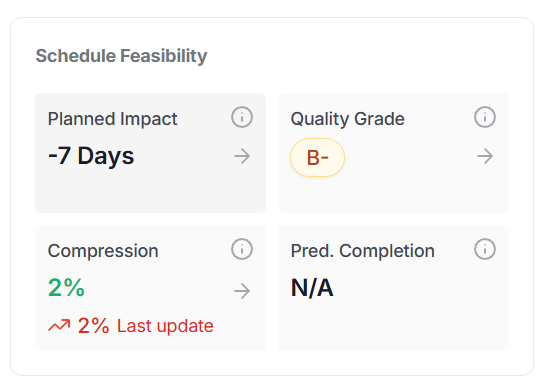

Schedule Feasibility:

This section will show you the feasibility of your schedule including:

  • Planned Impact: The total change to the project’s end date caused by updates to the planned schedule to date.
  • Quality Grade: An assessment of the project schedule’s structural integrity, based on Critical Path Method (CPM) best practices.
  • Compression: A comparison of the remaining effort in the current schedule versus the baseline schedule, indicating how much the schedule has been tightened or expanded.
  • Predicted Completion: An estimated project completion date based on past performance. This value is available once the project has reached at least 50% completion.

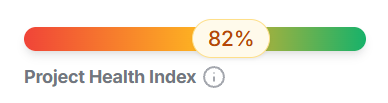

Project Health Index:
